Creative phasing and cost control. Passive House certified. Leads the strategic decisions — schedule acceleration, geothermal relocation, early release packages. Pollard is his #1 priority.
100% dedicated. Invented the "dance floor" auditorium method — proven on Doherty, South High, West Springfield, Walpole. The person who builds the 750-seat theater.
Owns the budget from SD through final reconciliation. Led Agawam geothermal redesign saving $1M+. 4 estimators and 3 MEP specialists from day one.
Decades of occupied campus experience. Phased construction planning. Constructability expertise that drives procurement strategy and field logistics.
36 years experience. Bridges preconstruction strategy with construction execution. Deep MBTA and transit-adjacent project expertise.
Dedicated from day one to manage all MBTA coordination — credentialing, flagging, ROW training. This is not a side responsibility. It's her job.
Professional Structural Engineer. Reviews steel connections, gym structure, auditorium fly loft. Catches coordination issues before they become field problems.
VP of CM Services. Lives in Needham. His kids are in the school system peer group. Community outreach, Town Meeting strategy, public communication.
The community chose to invest in its existing neighborhood. That means occupied campus construction, phased logistics, and zero disruption to school operations. We've planned for all of it.
Bringing 6th graders back to Pollard changes the building program, the site logistics, and the community dynamics. It also opens the door for High Rock and Mitchell to begin their own next chapter.
A 750-seat community theater is a generational asset. It requires specialized construction methods, structural coordination, and an acoustics-first approach. Matt Wilder's "dance floor" method makes it buildable.
We didn't start with a schedule. We started with understanding why this project exists and what this community needs. Every phasing decision, every logistics plan, every cost estimate flows from these three choices.
A number without context doesn't help Needham make decisions. We developed a layered conceptual dashboard showing every cost driver, benchmark source, and MSBA reimbursability — so every dollar has a story.
We assessed whether a single-phase approach could work. The site constraints, occupied campus requirements, and MBTA adjacency make phased construction the clear right answer — and we've optimized the phasing to save a full year.
We evaluated routing construction traffic through DeFazio Park. Our analysis shows that Dedham Ave and Great Plain Ave provide safer, less disruptive access without impacting park operations or residential streets.
We considered distributed geothermal installations across the campus. Consolidating all ~120 wells at Warner Field enables single-mobilization drilling, saves approximately $1M, and eliminates noise near the school and homes.

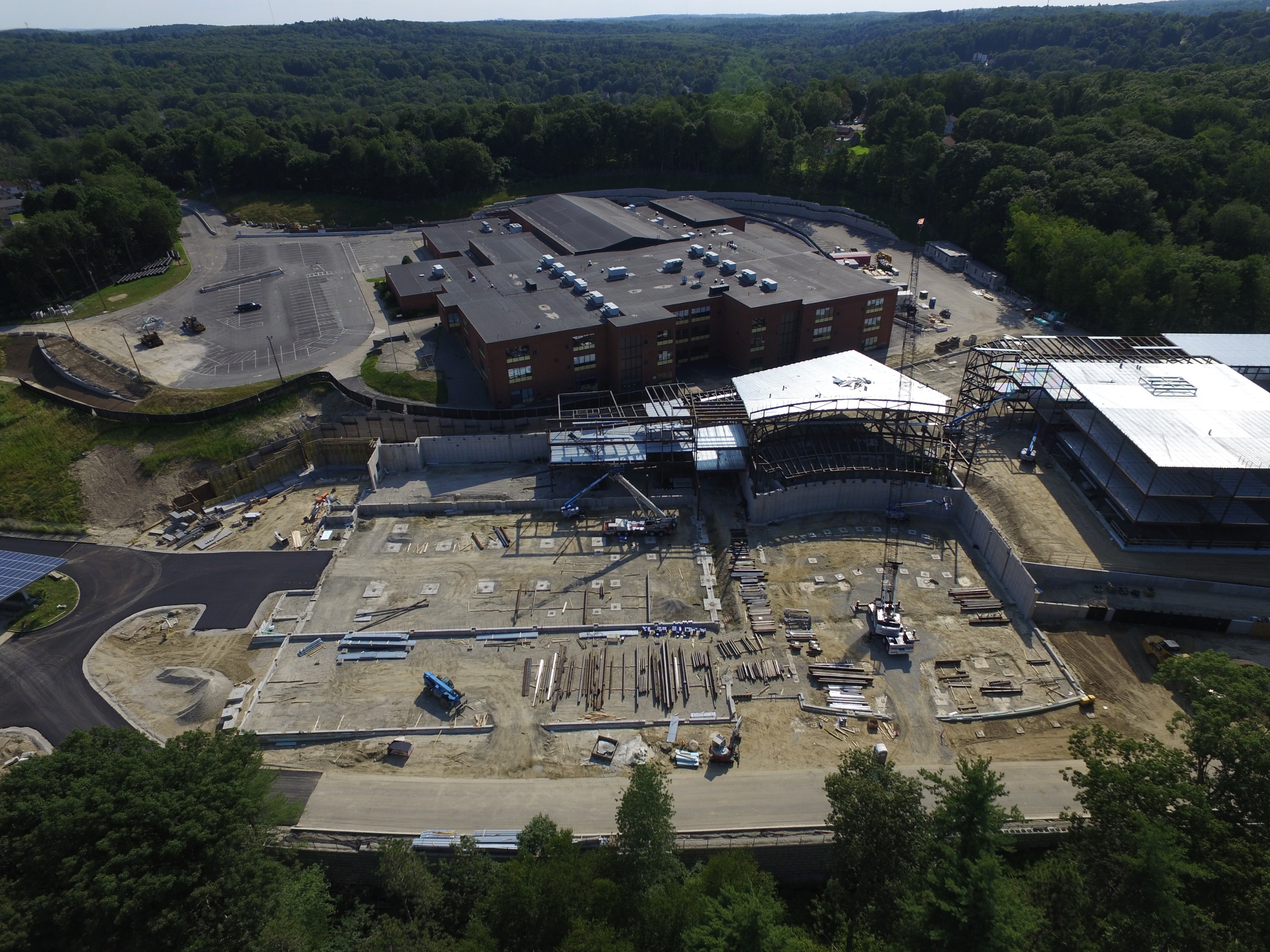

Fontaine + Dimeo joint venture. 422,000 SF. New high school on occupied campus. Regional Best Project recognition. Same JV partnership, same management systems, same trust.
Comprehensive renovation and addition achieving LEED Gold certification. Complex occupied site, phased construction, community engagement throughout. Direct parallels to Pollard's sustainability and logistics challenges.
“I believe our community would be in good hands.”
Geothermal • MBTA • Safety • Schedule • Preconstruction • Modular
Single mobilization eliminates redundant drilling setup, simplifies dewatering, reduces site disruption. Drilling happens away from students, staff, and neighbors.

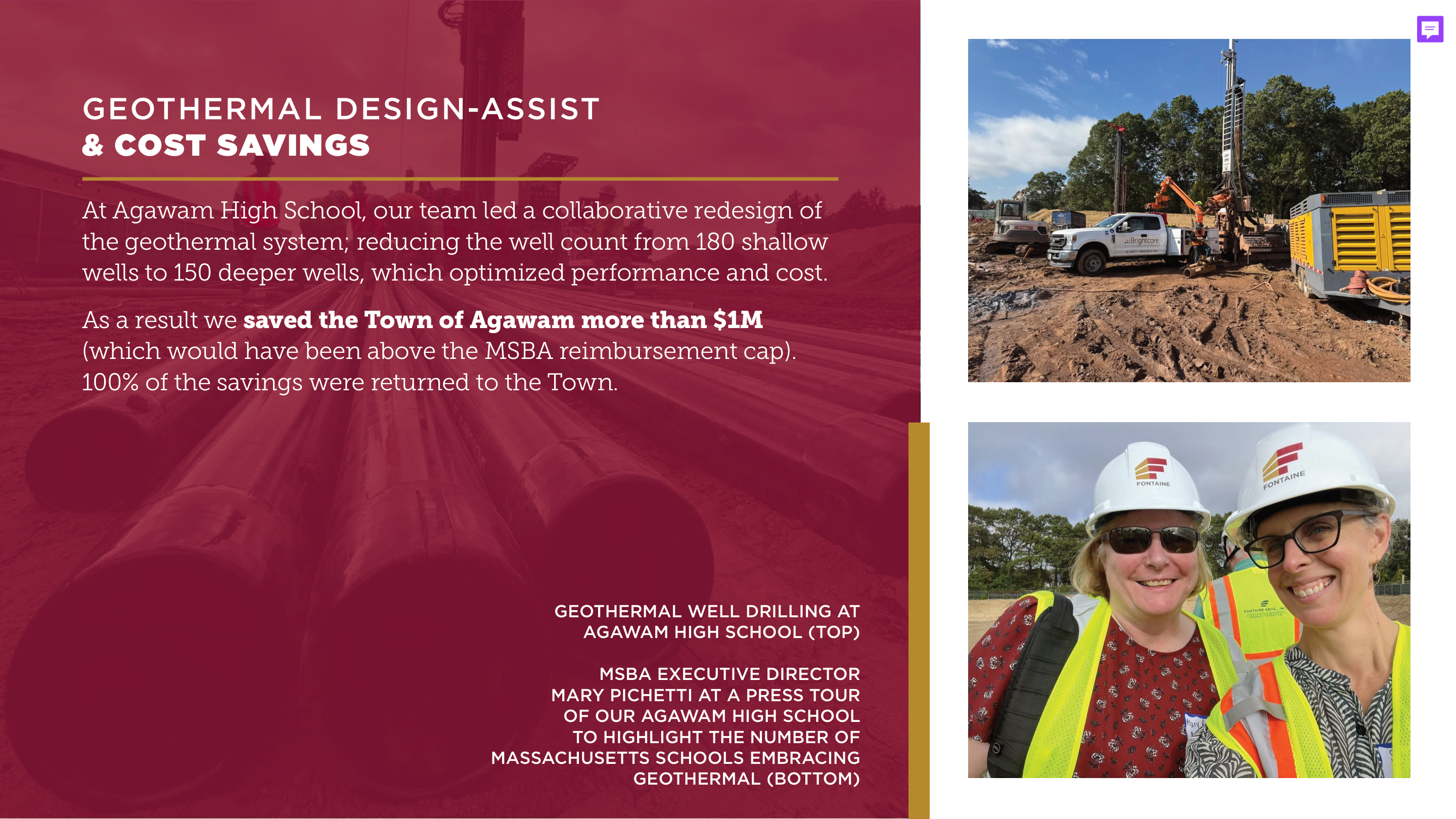

149 boreholes, $4.575M field installation + $1.155M heat pumps + $300K mechanical room. Chelsey led the redesign from 180 shallow wells to 150 deeper wells — saving over $1M for the Town of Agawam.
ROW training, credential verification, flagging services, protective fencing. Every worker entering the MBTA zone is trained and badged before they touch the site.
We know the MBTA Capital Delivery review timeline. We plan around it. No surprises, no schedule impacts. Flagging is budgeted as a defined cost — not buried in contingency.
Green Line adjacent. Full MBTA coordination. Dimeo led all rail interface safety, credentialing, and flagging operations. Completed successfully.
Green Line and North Station. Transit-adjacent construction in one of Boston's most constrained sites. Same team, same protocols.
All construction traffic via Dedham Ave and Great Plain Ave to I-95. Zero construction vehicles through residential neighborhoods or the school's main entrance.
Bus loop maintained throughout all phases. Safe walking and biking paths preserved. Drop-off and pickup operations never disrupted.
Expanded Harris Ave lot + temporary northwest lot during Phase 1. Warner Field parking during Phase 2. Net increase in available parking at every stage.
Only Warner Field is used for geothermal drilling. All other DeFazio fields remain fully operational throughout construction. Warner Field fully restored at completion.
Life safety and active shooter protocols updated per phase. Fire department walkthroughs before each transition. All workers background-checked and badged.
High-impact work scheduled during school hours when possible. Restricted weekend and evening operations. Seasonal adjustments for testing seasons and community events.
Phase 1 starts July 2027 (vs. RFP baseline March 2028). Substantial completion December 2029 — students move in over winter break. 29 months total.
Phase 2 completes August 2031 (vs. RFP baseline July 2032). Demo, foundations, fit-out of the Grade 6 Academy. Warner Field fully restored. 20 months total.
ERP 1: Site enabling & geothermal drilling (Apr 2027) • ERP 2: Sitework & concrete foundations (Aug 2027) • ERP 3A: Structural steel (Nov 2027) • ERP 3B: Long-lead electrical switchgear. Each package builds on the last — no gaps, no idle time.
Benchmarking against MSBA bid results. Trade input from actual subcontractor pricing. Early procurement roadmap to de-risk long-lead items.
Clash detection, risk identification, site logistics refinement. Brian Davies reviews every mechanical system for operability and BMS compatibility.
Comprehensive estimates, scope boundary definition, phasing strategies for occupied schools. We start qualifying subs here — not at bid time.
Bid-day RFI identification, allowance confirmation, procurement schedule. The GMP is real because we know what things actually cost to build.

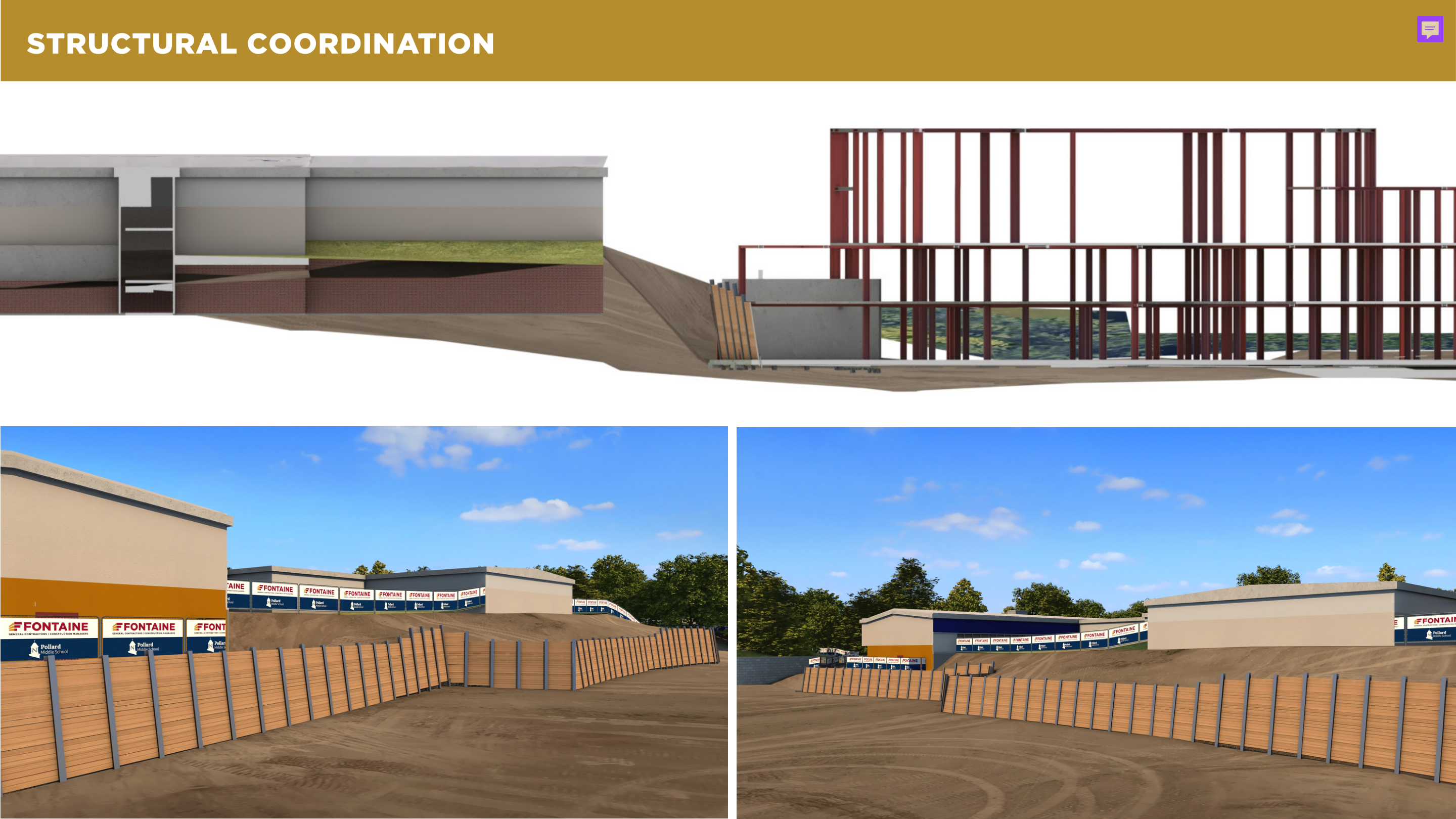

Example: Structural coordination issue caught during design review — Danielle Judge, PE
As the only CM + GC in this room, we hold direct contracts with Division 10 subs — tack boards, markerboards, door/frames/hardware, fencing, playgrounds, SOE. Other firms bundle these into big packages under a drywall contractor or sitework sub. We control the data flow, the risk, and the insurance directly.
Subcontractors who don't price Consigli or Bond jobs will price ours. That means more bids on every package, more competitive pricing, and more options for Needham. Our self-perform capability changes the bidding dynamic.
Our conceptual dashboard isn't theoretical. It's built from verified actuals: Agawam geothermal ($4.6M), Walpole GMP ($95.3M / 162K SF), Peck MS ($58.8M), and Shane Sampson auditorium benchmarks. Every line item has a source.
With potential support of excavation needs on this site, we would propose to either buy that directly or get the engineering to 90% and work to assign it to the subcontractor. You'll know the methods and the costs before we break ground.
Move district-owned modulars to Pollard site. Supplement with additional units as needed. Lowest capital cost, fastest mobilization.
Purchase pre-owned units from districts phasing out modulars. Watertown and Nauset have significant inventory available now.
Custom-built to Pollard specifications. Highest quality and longest lifespan. May serve district needs beyond this project.
Infrastructure costs include site preparation, utility connections, ADA compliance, fire alarm tie-in, and temporary walkway construction.
Community • CM+GC Advantage • Technology • Track Record • Sustainability
VP of CM Services. Lives in Needham. His kids are in the school system peer group. He walks these streets. He's accountable to this community not just professionally — personally.

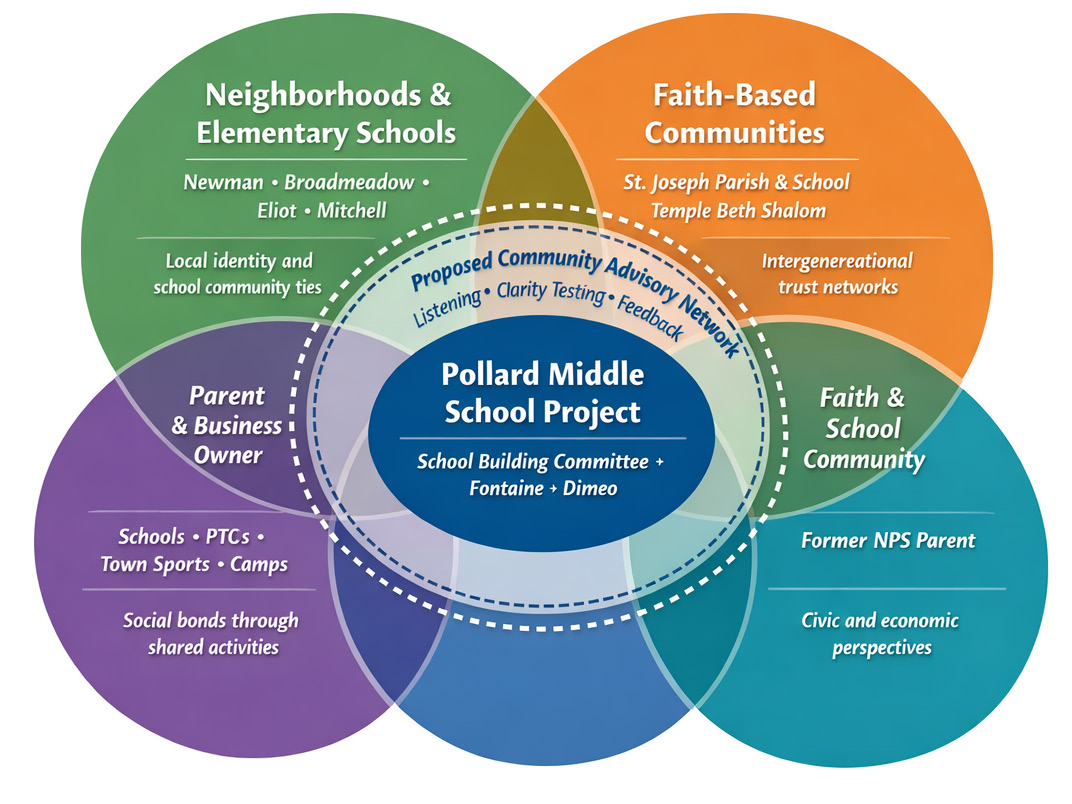

Engaging Needham's interconnected social circles — elementary schools, faith communities, PTOs, town sports, camps. Pre-construction meetings, monthly mailers, QR-code access to live project visualization.
Built in-house. Customized for Pollard. Construction updates, traffic routing, noise-impact windows, team bios, and interactive phase explorer.
Udor answers community questions 24/7. Ask it anything about the project. The best human communication, enabled by technology.
Layered estimate with MSBA reimbursability analysis, verified benchmarks from 4 comparable projects, and cost-to-Needham breakdown.
Full phasing walkthrough with voiceover. Every phase visualized. Shareable with the community via QR code at Town Meeting.
$268M joint venture. 422,000 SF. New high school on occupied campus. Regional Best Project recognition. Fontaine + Dimeo together.
235,075 SF. Redesigned geothermal from 180 shallow to 150 deeper wells. $1M+ savings. MSBA Executive Director press tour. Same approach for Pollard.
162,000 SF. 3-year occupied campus renovation. $95.3M GMP (~$588/SF). Auditorium using Matt Wilder's "dance floor" method. Key benchmark for Pollard pricing.
177,000 SF. Two-phased new construction just 14 feet from the occupied school. Studio G was the design associate. Directly applicable to Pollard.
“Working with Fontaine + Dimeo has been a seamless experience.”
“I believe our community would be in good hands.”

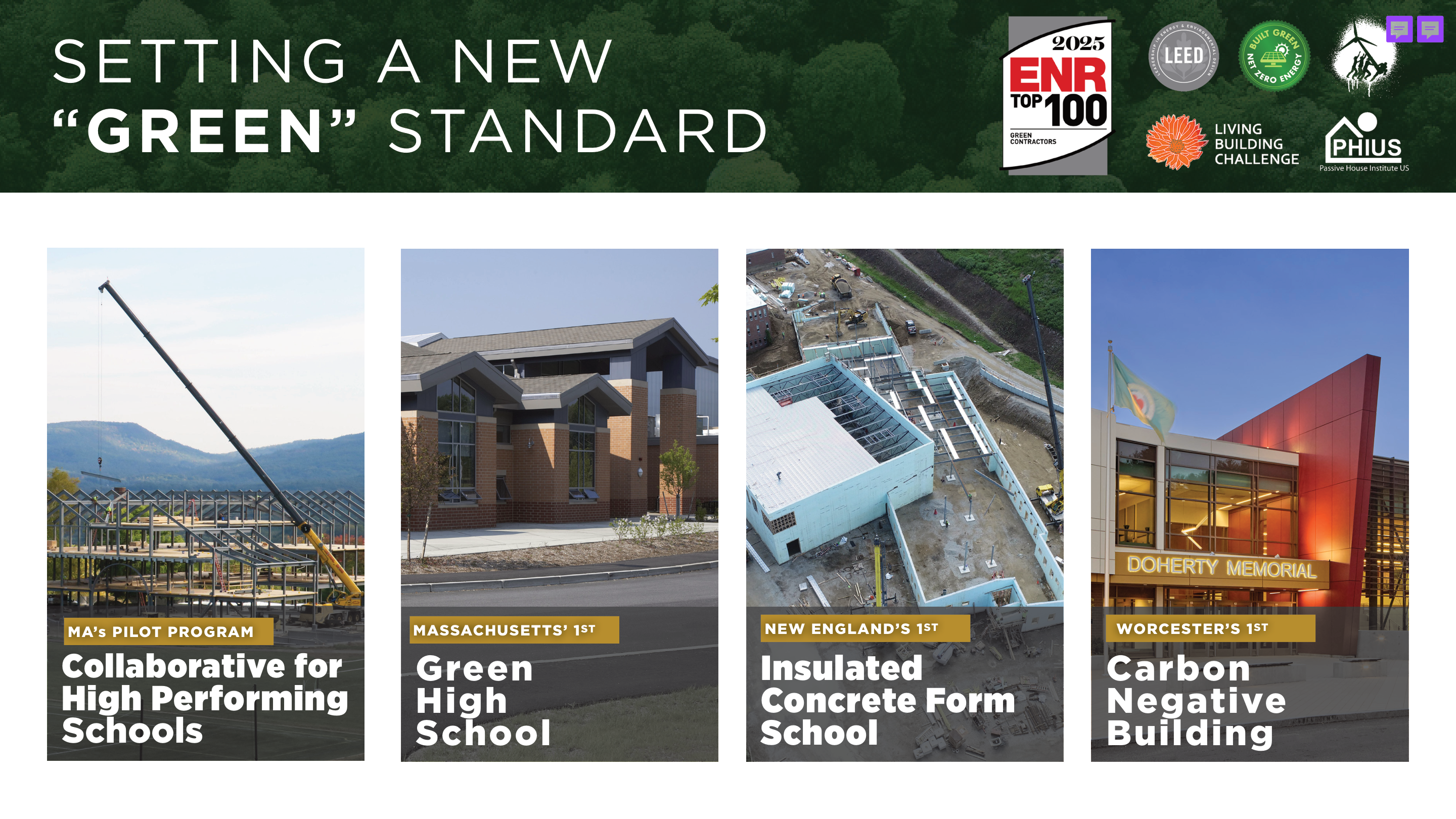

All-electric building. Ground-source heat pump system (~120 boreholes). Solar-ready parking canopy. Designed for Net Zero performance from day one.
Gold pathway with 63-point scorecard. Enhanced indoor environmental quality. Low-emitting materials. Advanced daylighting and operable windows.
Every installer's contract includes a full year of service. Consumption tracked against Net Zero targets. BAS integration verified before handoff.
We assessed options before we proposed. We developed a phasing plan, a cost dashboard, and a community communication platform — before you asked us to.
Wider subcontractor pool. Lower costs. Direct risk control. Our GMP is built from what things cost to build — not what they cost to manage.
Two family companies. Combined 200 years. And one of us already lives here. Pollard will be our largest, highest-priority project for the next three years.
